In our experiments, a genetic algorithm finds and saves solutions to an
open shop scheduling problem , the problem is changed slightly
to
, and appropriate solutions to
are injected
into the initial population of the genetic algorithm that is trying to
solve the new problem
. If the cases from
contain
good building blocks or partial solutions, the genetic algorithm can use
these building blocks or schemas and quickly approach the solution to
. The results show that compared to a genetic algorithm that
starts from scratch (from a randomly initialized population), the
genetic algorithm with injected solutions very quickly finds good
solutions to
and that the quality of solutions after
convergence is usually better.
The open-shop scheduling problem is an important practical scheduling
problem, but is known to be very hard to solve in a reasonable amount of
time. Re-scheduling is also an important aspect of the problem in the
real world. It involves modifying a schedule in the process of execution
in order to take account of a changing environment. In the general open-shop scheduling problem, there are j jobs and m
machines. Each job contains a set of tasks which must be done on a
different machine for a different amount of time, with no a-priori
ordering on the tasks within a job. The problem is to minimize the
makespan, the total time between the beginning of the first task till
the end of the last task. A valid schedule is a schedule of job
sequences on each machine such that a machine is not processing two
different tasks at the same time, and different tasks of the same job
are not simultaneously being processed on different machines. We must
take into account both resources and time constraints with the aim of
finding a valid schedule with a minimum makespan. The OSSP differs from
the job-shop scheduling problem in that there is no a-priori
ordering on the tasks within a job. This leads to an extremely large
search space. For example on a
OSSP, there are 25!
different task orderings which is approximately equal to
different valid schedules.
In open-shop re-scheduling (OSRP), we need to be able to handle changing
conditions on the shop floor. For example, jobs may be canceled,
machines may fail, or we may run low on inventory. If the work has not
yet begun on the current schedule, then a simple way of re-scheduling is
to rerun the GA for this scheduling problem in the changed
environment. We need quick and efficient methods of re-scheduling to
tackle the problems of frequently changing environments. In this paper
we handle the case of a machine breaking down and being replaced with a
new, faster machine. is the problem with the old machine while
is the problem with the new machine, where the processing
times of all tasks on the new machine have been decreased by 10 time
units; note that we have made sure that
is similar to
. We use individuals from a GA's run on
as cases for
the re-scheduling problem,
. After using a variety of criteria
to pick individuals for cases and to choose how many individuals to
inject into the initial population of size 200 run for 300
generations, we obtained good performance under the following conditions
(More details on the encoding and genetic operators are available in
[Xu and Louis, 1996]).
We mutated these six individuals picked from intermediate generations
and inject all eight individuals into the initial population of the GA
for the OSRP. Figure 2 compares the average performance of a
genetic algorithm initialized with these cases with a randomly
initialized GA on two different OSRP problems. We call the
the GA that uses cases a Case Initialized Genetic
AlgoRithm or CIGAR, and the Randomly Initialized
GA, RIGA in the rest of this paper. The graphs in this section display
the best makespan averaged over 10 runs with different random seeds.

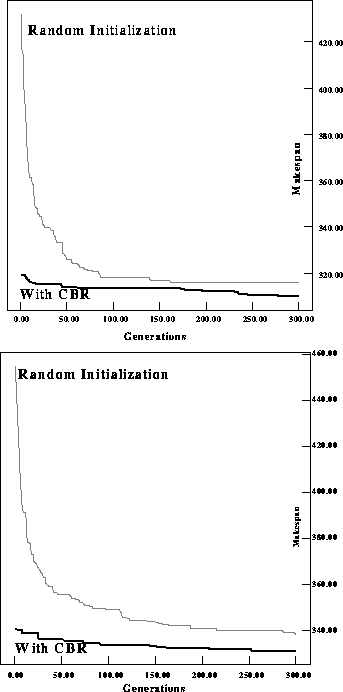

Figure 2: Comparing performance of a RIGA with a CIGAR for 5x5 OSRP
problems.
We can see that the CIGAR starts with a much lower (better) initial best
makespan and that even after 300 generations CIGAR solutions are
better than solutions from a randomly initialized
GA. Table 1 compares starting and ending makespans for
eight different OSSP benchmark problems.
The
last column specifies the machine that was changed (picked
randomly). Notice that CIGAR does comparatively well in early
generations and provides good schedules more quickly than the randomly
initialized GA.
Table 1: Performance comparison of average makespan on 5x5 OSRP
problems
We get similar results on a set of five OSRP benchmark
problems. Figure 3 displays average best makespans over ten
runs with different random seeds on two of the problems. We increase the
population size to 300 and run for 400 generations on the
problems. Once again

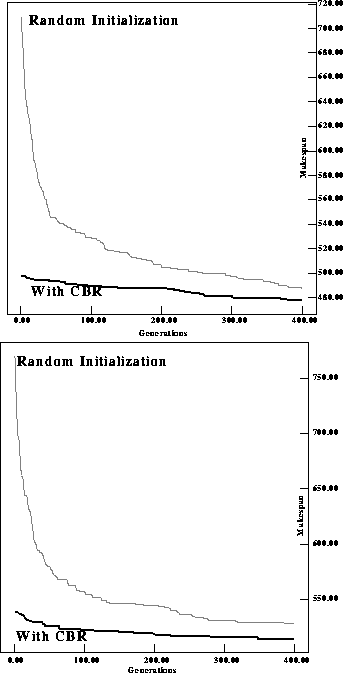

Figure 3: Comparing performance of a RIGA with a CIGAR for 7x7 OSRP
problems
the CIGAR does better, especially in early generations.
